2040 Campus Master Plan Update

Timelines

Timeline depicts six major steps towards completion of the CEQA/EIR process which is anticipated to take approximately 16-18 months from start to finish.  An arrow shows the Public EIR Scoping Meeting to be held on April 24, 2024, during the 30-day public review of a Notice of Preparation beginning on April 8 to May 8, 2024.

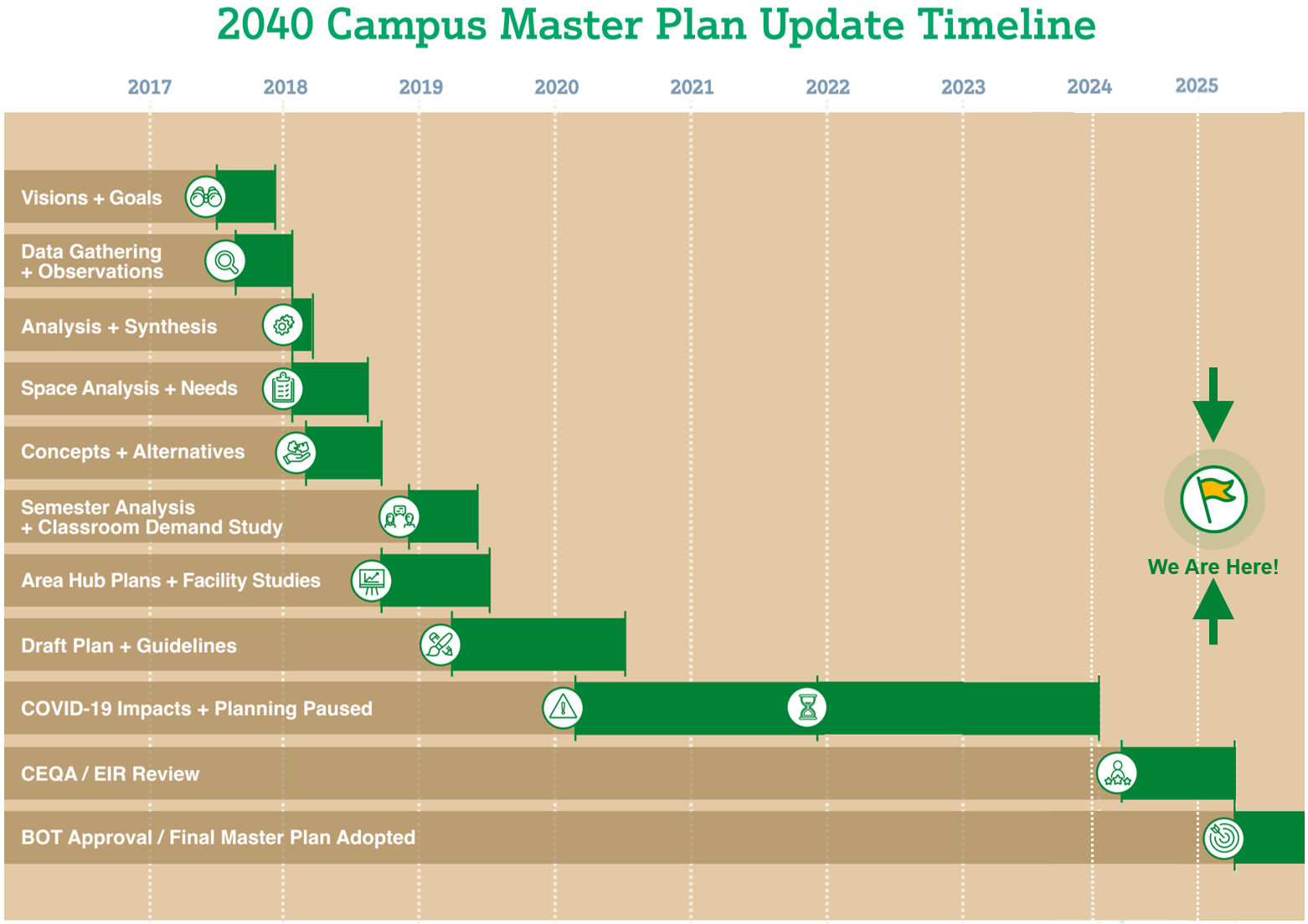

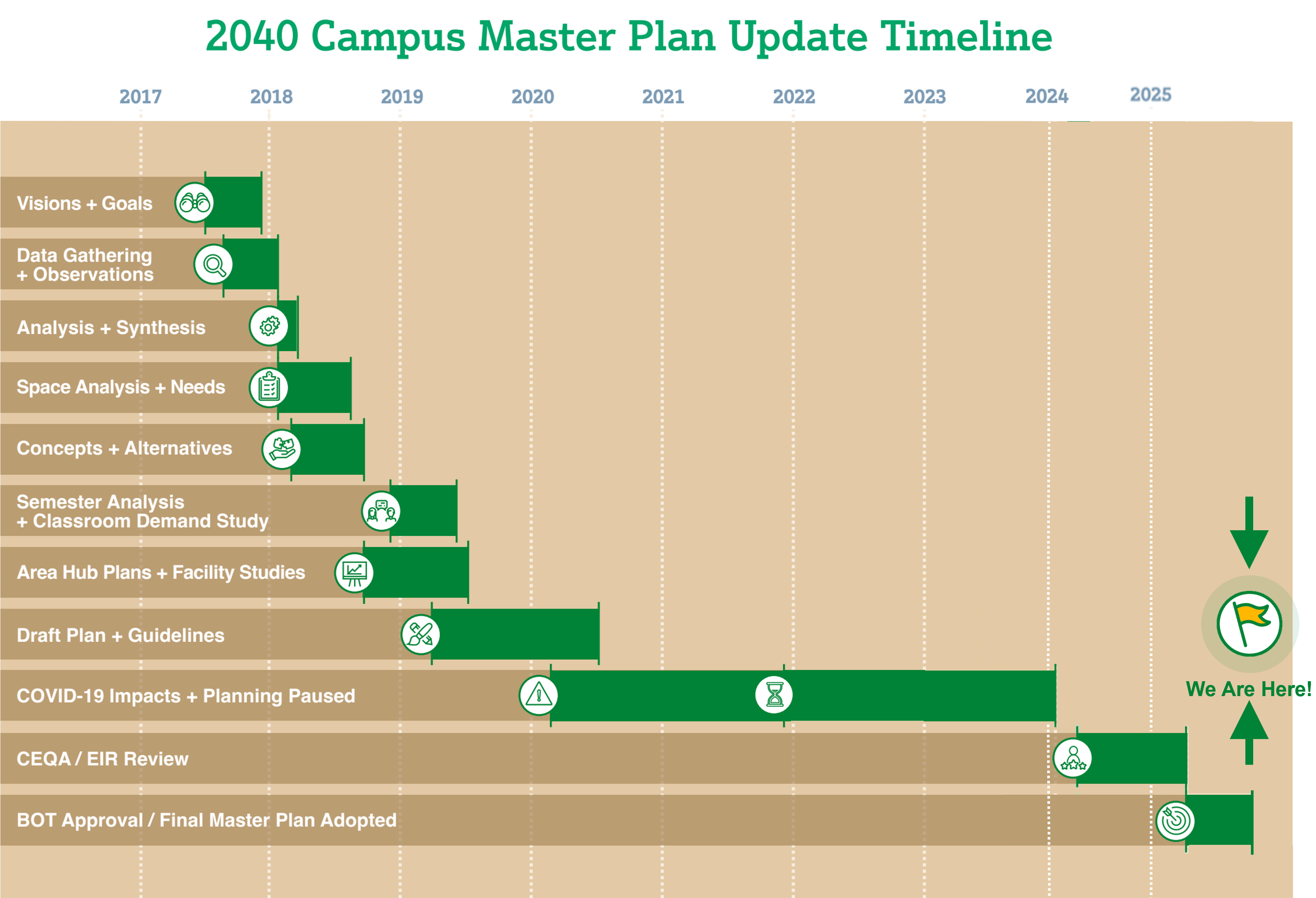

 2040 Campus Master Plan Update timeline.  Bar graph depicting major milestones towards development and approval of the 2040 campus master plan from years 2017 through 2025 timeframe. An arrow shows that the project is currently in the environmental review phase in year 2024 and approval is anticipated to occur in year 2025.
